Global SaaS Provider – Accelerated Data Center Decommissioning
Overview:
A global SaaS provider engaged Virnich to oversee the secure decommissioning and removal of server racks and cabling across multiple data centers. Shortly before the scheduled start date, the client expanded the scope to include the identification, audit, and secure packing of all data-bearing assets—adding significant complexity to the project. This change came with no adjustment to the timeline, as the work needed to be completed before an imminent end-of-lease deadline.
The Challenge
The new scope change increased the complexity and compliance standards required to complete the project within the same timeline. This wasn’t just a logistical adjustment; it was a complete operational shift that required a rapid adaptation to our planned processes. We were forced to re-engineer our entire approach in real time—mobilizing additional resources, deploying secure audit protocols, and coordinating across multiple teams and facilities—all while reducing risk and maintaining Virnich standards.
The Solution
- Assembled a 20-person team, all background-checked to meet security standards.
- Procured equipment for secure asset removal, storage, audit, and transport.
- Developed SOPs for each phase and location, including secure equipment handling for data-bearing assets.
- Continuously refined the plan in real time to address emerging operational challenges.
- Executed multiple workflows concurrently to maximize efficiency.
The Results
- Timeline – Estimated: 16 weeks → Completed: 9 weeks
- Cost Savings – 45% reduction in total project cost
- Client Outcome – Avoided additional lease penalties; full peace of mind
- Follow-up Work – Client awarded Virnich multiple additional data center transition projects
Why It Worked
- Precision Planning – SOPs ensured fast onboarding and clear execution.
- Execution Efficiency – Concurrent task planning accelerated progress.
- Compliance Focused – Full adherence to data security regulations.
- Scalable Team – On-demand flexibility to meet evolving needs.
Conclusion
Virnich’s ability to execute under pressure while maintaining full compliance resulted in a high-impact success. The project was completed early and under budget, solidifying Virnich as a reliable partner for future enterprise transitions.
Fortune 500 Tech Company – Rapid Facility Vacate
Overview
A top-tier software provider needed to vacate a data center quickly, requiring the removal of a significant volume of server racks and IT assets within an aggressive timeframe. With limited on-site infrastructure—including only one available loading dock—the logistics posed a substantial challenge.
The Challenge
The client needed to move 400 full server racks and 10 pallets of loose assets over 3 days, using a single dock, to meet strict deadlines. With thousands of pounds of IT equipment involved and zero margin for delays, any misstep would risk extending the estimated timeline and increasing costs.
The Solution

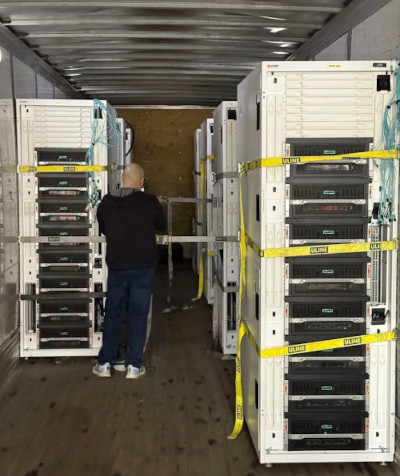

- We provided a customized logistics and ITAD solution focused on efficiency.
- Coordinating multiple truck arrivals while using only one dock (Estimated twenty 53' Dry Vans)
- Designing a continuous loading schedule to maximize throughput and eliminate downtime.
- Consolidating IT assets to minimize the number of trucks needed, optimizing both cost and efficiency.
- Our experienced team developed a precise loading plan, timing each truck’s arrival and departure to keep operations flowing without interruption.
The Results
-
Timeline Estimated - 3 days → Completed: 2 days
-
Operational Efficiency
- Trucks were loaded sequentially without any delays.
- Consolidating the loose assets reduced the number of total pallets.
- Loading pallets at end of trailer reduced the number of trucks required (Completed with 18 53' Dry Vans).
-
Cost Savings
- Reducing the total number of trucks required decreased transportation costs for the client.
- Completing the project ahead of schedule reduced time and onsite labor, decreasing costs for the client.
-
Client Outcome -
Project delivered on time and within scope, exceeding client expectations.
Why It Worked
- Precision Planning – Our Logistics team ensured clear scheduling and execution for each truck.
- Execution Efficiency – Once onsite, our team leaders were able to execute a plan to avoid any downtime or damages.
- Compliance Focused – Full adherence to the data center's loading dock regulations.
Conclusion
This project highlights our ability to respond immediately and execute flawlessly under tight deadlines. For enterprise clients and ITAD partners alike, we offer scalable, high-integrity services that are both rapid and reliable.
24-Hour Urgent Decommissioning Response
Overview
A leading ITAD company reached out with an urgent project: a decommissioning operation that needed to begin within 24 hours and completed within 6 hours. Upon receiving the request, our team launched a rapid deployment protocol. Within hours, we coordinated flights, equipment logistics, and boots-on-the-ground staffing to arrive at the site the very next day.
The Challenge
The client required decommissioning, packing, and transportation of 250 servers from a data center by end of the following day.
The Solution
- Mobilize two Virnich technicians with a capable on-site team.
- Perform inventory audit and asset tagging for chain-of-custody and compliance tracking.
- Safely de-cable and decommission 250 servers and networking assets.
- Pack & Palletize all assets using inserts, anti-static wrapping, and secure banding.
- Coordinated dedicated, secure transportation to the client’s processing facility using IoT trackers.
The Results
- Timeline - Team on-site within 24 hours of request. Completed all work within 6 hours.
- Results - Assets delivered on time without any issues.
- Client Outcome - Project completed on time and within scope, exceeding client expectations
- Follow-up Work - Client awarded Virnich multiple additional data center decommissioning projects.
Why It Worked
- Precision Planning – Our ability to mobilize an experienced team and complete the project within all scope.
- Execution Efficiency – Maximize efficiency by aligning team strengths from decommissioning through packing, ensuring minimal disruption.
- Compliance Focused – Full adherence to equipment handling and ESD protocols.
- Scalable Team – Providing an experienced team that works well under strict timelines.
Conclusion
This project highlights our ability to respond immediately and execute flawlessly under tight deadlines. For enterprise clients and ITAD partners alike, we offer scalable, high-integrity decommissioning services that are both rapid and reliable.
